CHL - CEMENT HYDRAULICS LOG -
A PROVEN, VISUAL, SIMPLE, STRAIGHT FORWARD ADDITION FOR
THE LOG AND THE LOG HEADING FOR THE INITIAL UP OR DOWN
ZONE ISOLATION MEETING, PLUS ANALYSIS FOR THE DESIGNER
OF THE CEMENT JOB
WHEELIS ENGINEERING,LTD
SOMETHING NEW FOR CEMENT EVALUATION FOR 2012 –
THE CHL INTERNET PROGRAM -
A PROVEN, VISUAL, SIMPLE, STRAIGHT FORWARD ADDITION TO -
Assist and add confidence in the initial zone isolation determination
Masure the cement curing and cement compressive strength at the time of the log
Indicate cement placement flow pattern and measure the cement placement efficiency
Indicate channel size and channel size cutoff, plus insight into channeling continuity
Record the hole size and the cement top relationships
Provide a heading insert to document the intervals of critical isolation
Document and help analyze squeeze job results
Document in one place the well data and cementing data
Help with cementing field studies for the next well in the area
Add cement compressive strength to frac vs. production studies
Initiate channel flow analysis on wells with questionable production
CHL INTRODUCTION -
WHAT ARE THE RANGE OF VALUES THAT DEFINE THE SUCCESS OF YOUR CEMENT JOB?
A TWO MILLIVOLT READING ALWAYS INDICATES A GOOD CEMENT JOB, BUT SOMETIMES A
TEN TO FIFTEEN MILLIVOLT READING CAN BE A GOOD CEMENT JOB ALSO.

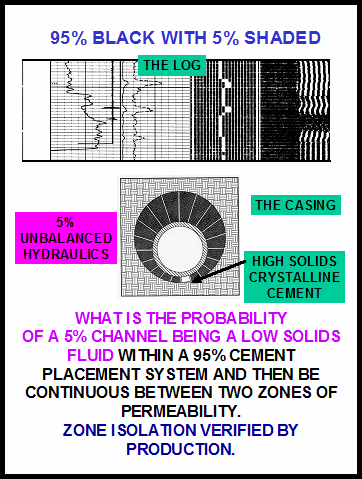

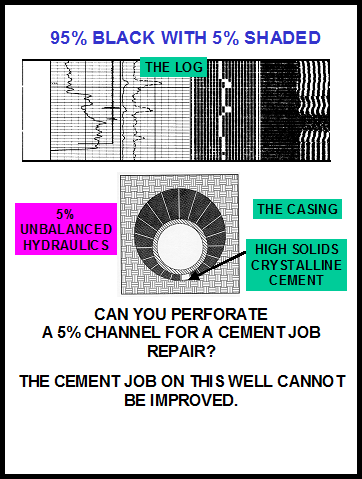

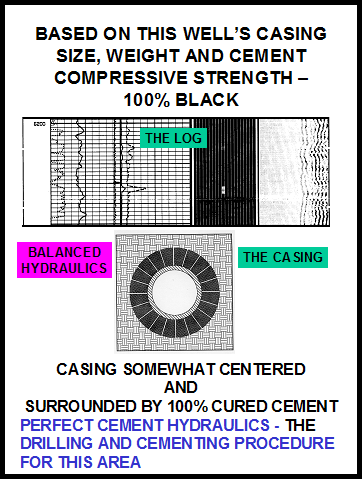

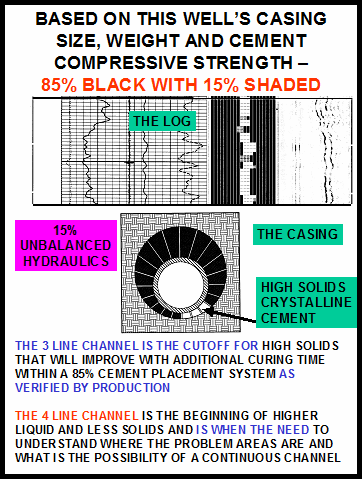

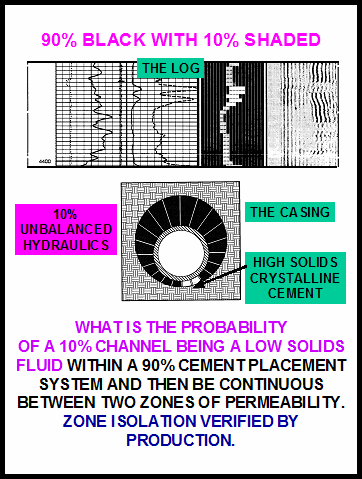

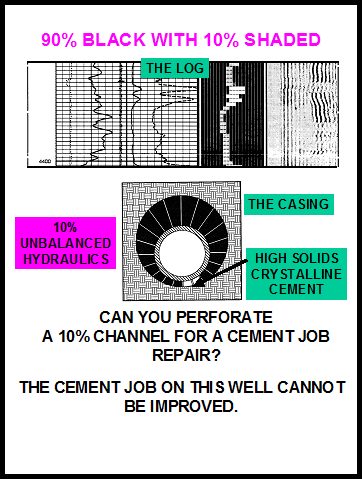

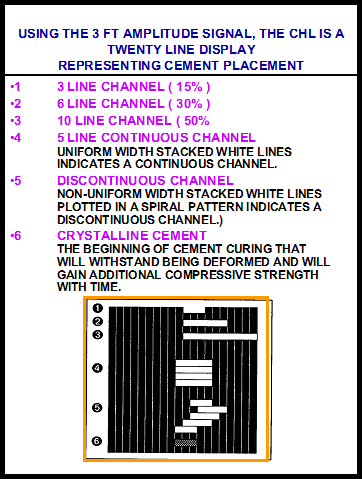

USING THE 3 FT AMPLITUDE SIGNAL, THE CHL IDENTIFIES THE 100% CEMENT READING FOR YOUR
CASING SIZE, CASING THICKNESS, AND CEMENT COMPRESSIVE STRENGTH AND COUPLES IT WITH

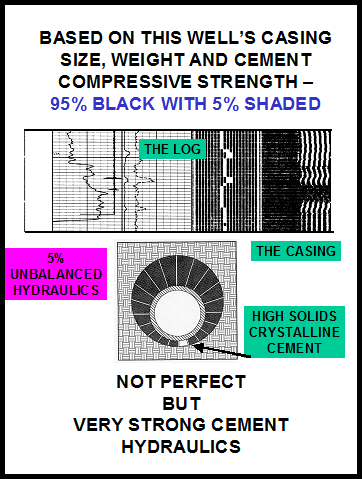

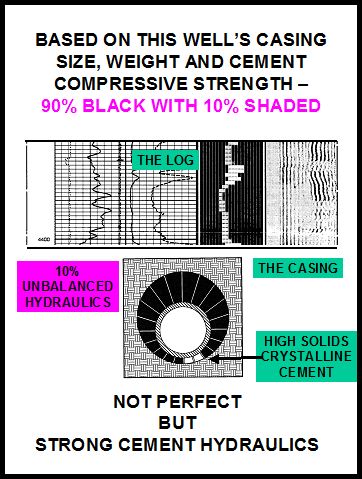

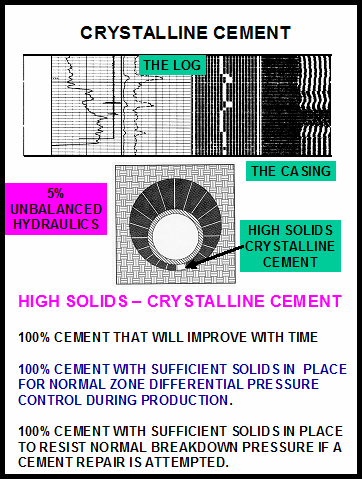

THE INTERPRETATION CUTOFF LIMIT FOR POSSIBLE 100% CEMENT, CRYSTALLINE CEMENT,
FOR A CONSISTENT INTERPRETATION IN A TWENTY LINE DISPLAY WITH SHADING FROM BLACK
TO GREY TO WHITE.

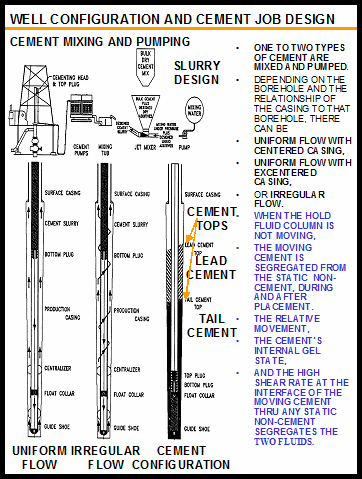

THE OVERALL CHL DISPLAY IS ALSO DESIGNED TO GIVE INSIGHT INTO THE CEMENT’S JOB

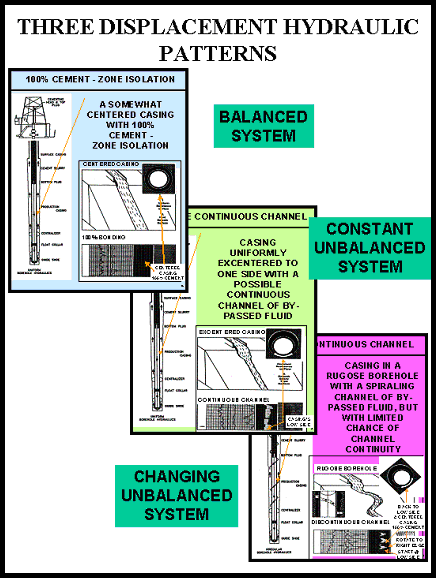

DISPLACEMENT PATTERN -

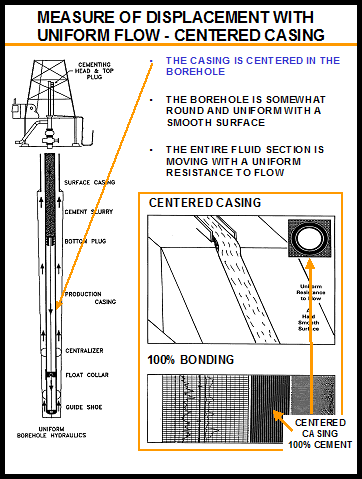

1. IS THE CASING CENTER WITH UNIFORM DISPLACEMENT,

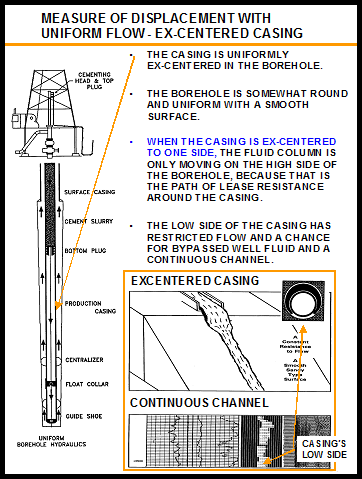

2. IS THE CASING EXCENTERED WITH UNIFORM DISPLACEMENT ON THE HIGH SIDE,
3. IS THE CEMENTING COLUMN ROTATING AND SPIRALING UP THE HOLE?

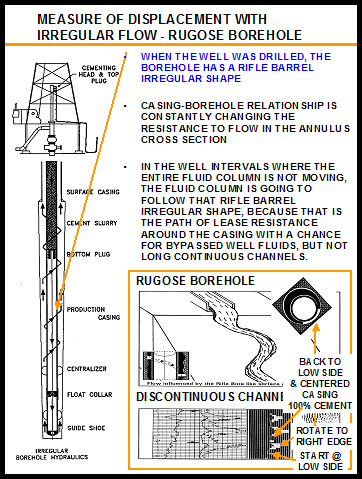

FROM THE CHL SHADING, IF A CHANNEL OF NON-CEMENT EXIST, USING THE HYDRAULIC DISPLACEMENT
PATTERN, DOES THE CHANNEL HAVE CONTINUITY TO A ZONE OF UNWANTED PERMEABILITY?
THE CHL PRESENTATION AND THE HEADING’S GOAL IS TO GIVE INSIGHT INTO THE PRESENT CEMENT
JOB AND ZONE ISOLATION ON THIS WELL WITH A LOOK TOWARD THE NEXT WELL IN THIS AREA.
THE CHL PROGRAM IS CURRENTLY WRITTEN IN A MICROSOFT FORMAT ACCESSIBLE ON THE
INTERNET AT www.addchl.com. THE CHL IS ADDED TO YOUR CEMENT EVALUATION PACKAGE
AFTER THE LOG IS RUN. WITH THE LAS FILE OF THE MAIN LOG SECTION WITH DEPTH AND
THE 3 FT AMPLITUDE DATA AND WITH THE PDF OR PBM FILE OF THE SAME MAIN LOG SECTION,
LOG ON TO THE CHL SITE AND ADD THE CHL. IT TAKES 10 TO 15 MINUTES TO RUN THE
CHL PROGRAM AND HAVE A CHL PDF OR A CHL PBM FILE READY TO PRINT OR E-MAIL.
DETAILS AND APPLICATIONS OF THE CHL ARE AVAILABLE IN THE ATTACHED POWER POINT
PRESENTATIONS AND THE LOG EXAMPLES

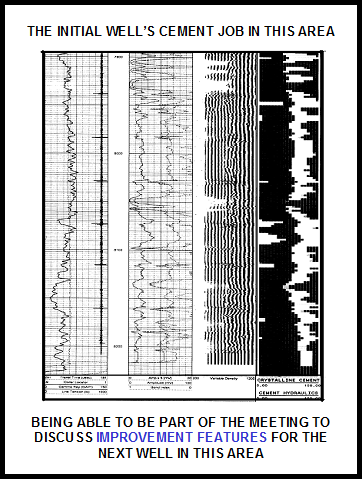

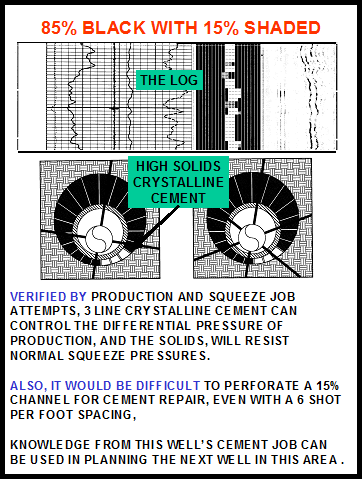

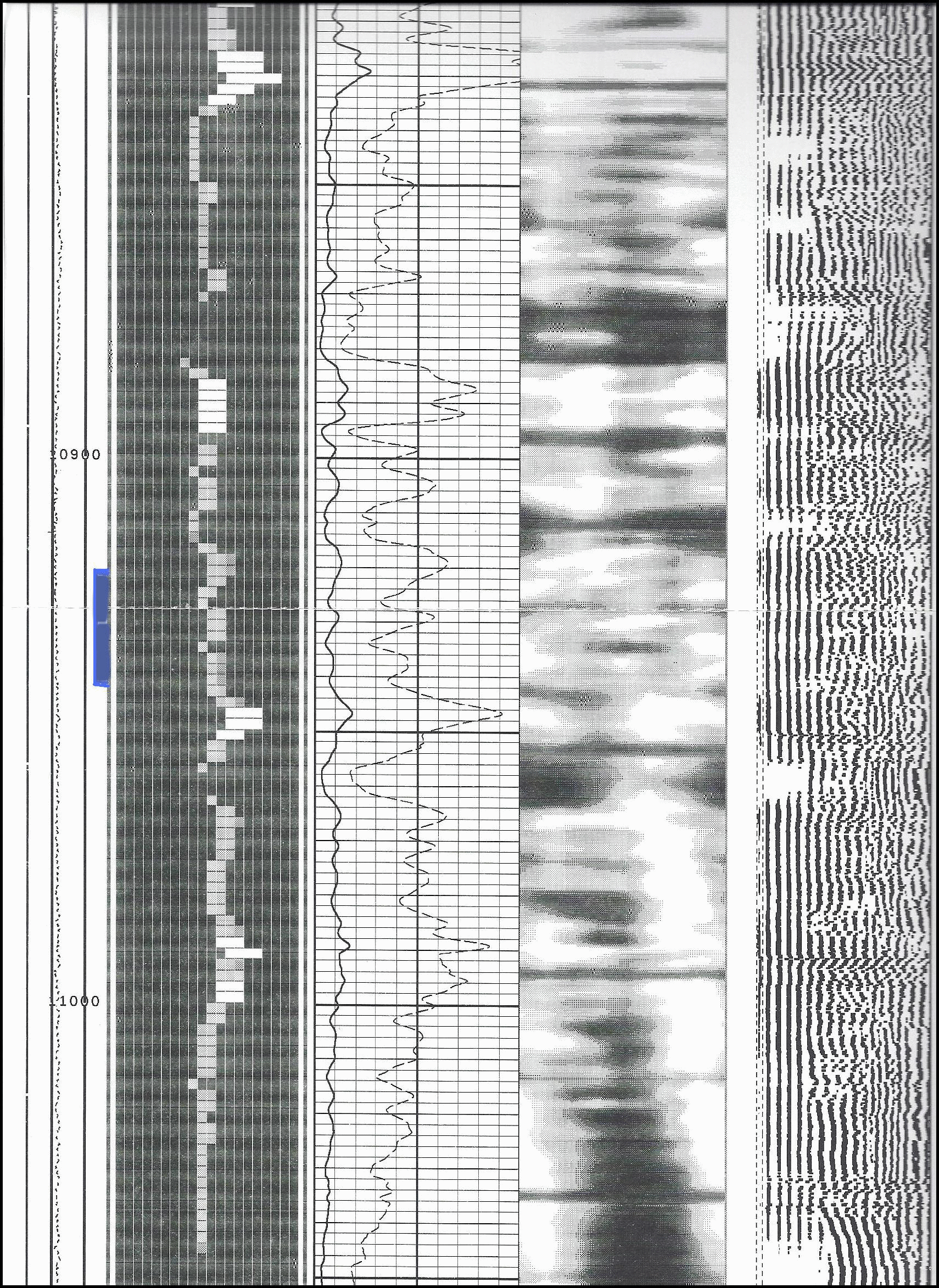

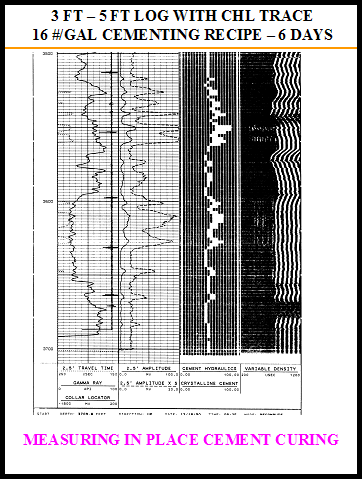

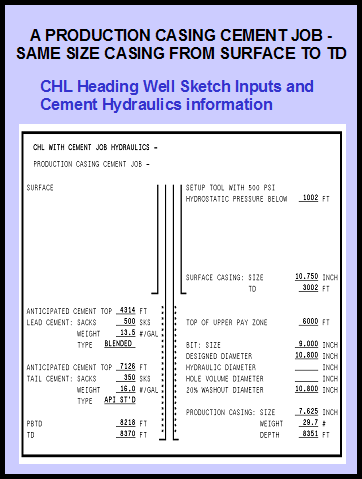

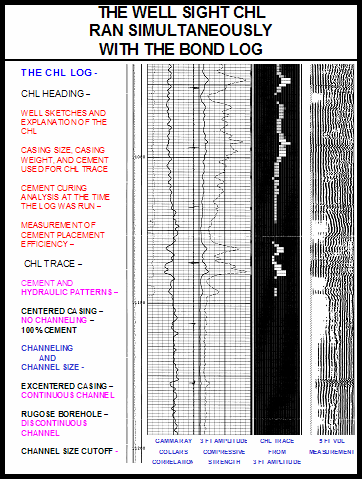

THIS IS WHAT THE CHL LOG LOOK LIKE - CHL LOG NO. 1
CHL LOG EXAMPLES & POWER POINT PRESENTATIONS
CHL LOG NO. 1
CHL HEADING, FREE PIPE SECTION,
MAIN LOG SECTION, REPEAT SECTION,
AND THREE HYDRAULIC PATTERNS TAIL

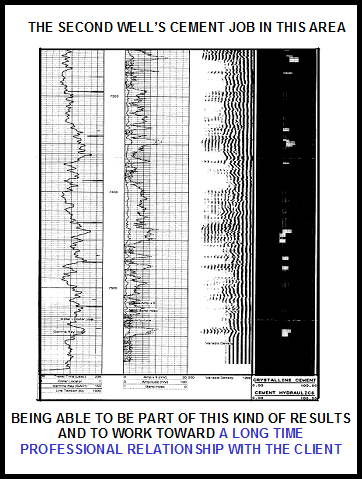

CHL LOG NO. 2
CHL HEADING, MAIN LOG SECTION,
WITH CHL, 3FT AMPLITUDE, SECTOR,
AND VDL SIDE BY SIDE DISPLAYS
THE CHL LOG IS A PROVEN PRODUCT WITH OVER FOUR HUNDRED LOGS RUN
FOR OVER NINETY DIFFERENT PRODUCTION COMPANIES.
THE CHL WILL BE AN ASSET TO SERVICE COMPANIES BY -
1. ASSISTING AND ADDING CONFIDENCE IN THE INITIAL ZONE ISOLATION DETERMINATION FOR
EACH WELL.
2. THE CHL LOG AND PROGRAM IS A TRAINING AND TEACHING AID FOR BETTER
UNDERSTANDING OF OIL WELL CEMENTING FOR A BETTER CEMENT EVALUATION
INTERPRETATION.
3. THE TRAINING AND TEACHING CAN BE REVIEWED THRU THE CHL WEBSITE
SCREENS AND THE ABOVE POWER POINT PRESENTATIONS.
4. THE CHL PROGRAM HAS THE POTENTIAL TO HELP CREATE DIALOGUE BETWEEN
PARTIES FOR COMMUNICATION TO HELP ESTABLISH A RELATIONSHIPS FOR SUCCESS
FOR BOTH THE PRODUCTION COMPANY AND WIRELINE SALES WITH BETTER CEMENTING
JOBS ON FUTURE WELLS.
5. HELP EACH SERVICE COMPANY’S GOAL TO INCREASE MARKET SHARE AND CASED HOLE
REVENUE IN THE NEW WELL COMPLETION MARKET.
FOR THE CEMENT JOB DESIGNER AND THE PRODUCTION COMPANIES
DOING CEMENT EVALUATION FIELD STUDIES BEFORE THE NEXT NEW WELL COMPLETION,
THE CHL OFFERS -
1. ASSISTING AND ADDING CONFIDENCE IN THE INITIAL ZONE ISOLATION DETERMINATION FOR
EACH WELL.
2. THE CHL MEASURES AND DOCUMENTS THE CEMENTING RECIPE’S CURING PERCENTAGES
AT THE TIME OF THE LOG.
3. THE CHL CONSISTENTLY MEASURES THE CEMENT DISPLACEMENT EFFICIENCY PERCENTAGE.
4. THE PROGRAM OUTLINES THE RELATIONSHIP BETWEEN THE CEMENT TOPS AND THE
HOLE SIZE.
5. THE CHL ISOLATION ZONE SECTION DOCUMENTS THE CRITICAL INTERVALS OF INTEREST.
6. IF THERE WAS A SQUEEZE JOB, THE CHL SQUEEZE ANALYSIS SECTION DOCUMENTS THE
CEMENT REPAIR EVALUATION.
7. THE CHL HEADING DOCUMENTS THE CEMENT JOB.
THE CHL HELPS ORGANIZE THE CRITICAL AREAS OF CONCERNS FOR THE FIELD STUDY TO HELP PLAN
THE NEXT NEW WELL COMPLETION.
FOR A REVIEW THE CHL CEMENT EVALUATION INTERPRETATION APPROACH THAT CAN BE ADDED TO YOUR PRESENT CEMENT EVALUATION PACKAGE ACTIVATE THIS ATTACHED POWER POINT PRESENTATION.
ANY QUESTIONS ABOUT THE CHL INTERPRETATION APPROACH,
AND THE CHL INTERNET PROGRAM CONTACT BILL WHEELIS AT
WHEELIS ENGINEERING, LTD, PHONE NUMBER 1 – 504 – 393 –0263
OR E-MAIL wwheelis@cox.net.
ALSO THE QUESTION OF WELL PRODUCTION -
WHAT RATE SHOULD BE PRODUCING
VS
WHAT RATE IS PRODUCING ANALYSIS

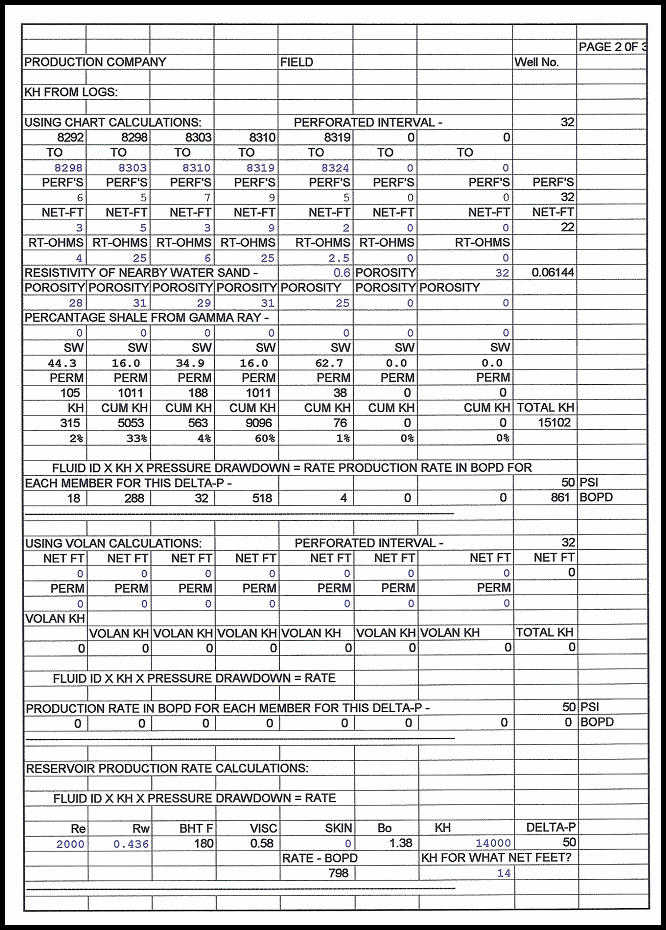

USING POROSITY AND WATER SATURATION FOR PERM INDICATIONS
TO GET THE SOUGHT AFTER DOWNHOLE KH VALUE
AN EXCEL SPREADSHEET FOR BOTH OIL WELLS AND GAS WELLS TO
ORGANIZE THE PRESENTATION OF THE LOG INDICATED IDEAL DOWNHOLE
PRODUCTION RATE CONVERTED TO THE SURFACE RATE AND FLOWING PRESSURE
FOR COMPARISON TO THE WELL TEST SURFACE RATE AND FLOWING WELL
HEAD PRESSURE
* COMPLETION INTERVAL DEPTHS
* BOTTOM HOLE PRESSURE SELECTION
* FLUID DATA AND FLUID PARAMETERS
* POROSITY AND WATER SATURATION FOR PERM INDICATIONS
* KH AND KH FLOWING PROFILE
* RESERVOIR PRODUCTION RATE FOR SELECTED RESERVOIR DRAWDOWN
USING DARCY, VOGEL – DARCY, AND JONES IPR
* MATCHING THE RESERVOIR DOWNHOLE RATE WITH THE WELL’S
COMPLETION HARDWARE USING NODAL ANALYSIS FOR THE MATCHING
SURFACE RATE AND FLOWING PRESSURE

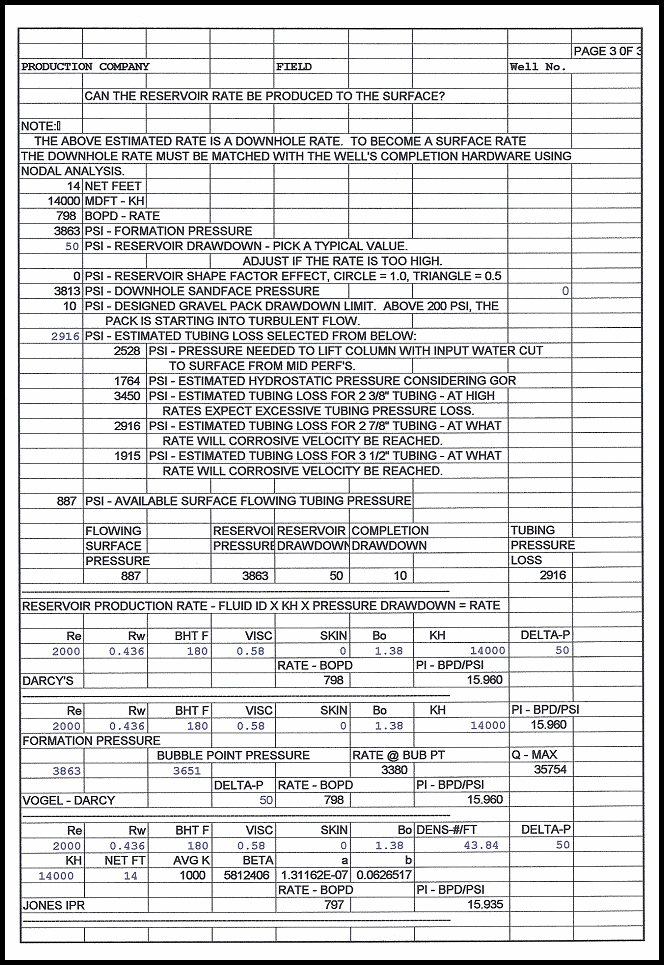

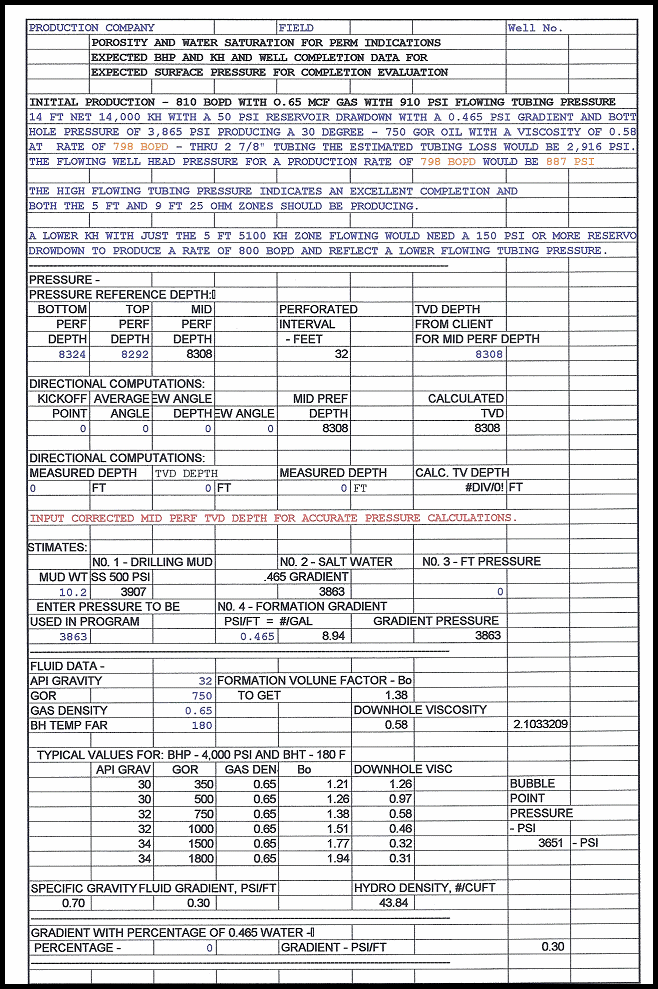

EXAMPLE OF THE EXCEL SPREADSHEET FOR AN OIL WELL –
QUESTION FOR THIS OIL WELL WITH TWO HIGH PERM LENSES, ARE BOTH
LENSES FLOWING AT INITIAL PRODUCTION?
FOR A COPY OF THE EXCEL SPREADSHEET ONE FOR OIL WELLS AND ONE FOR GAS WELLS
E-MAIL wwheelis@cox.net. THE TWO EXCEL FILES WILL BE ATTACHED TO THE REPLY.
OIL FIELD CONSULTING SERVICES
WHEELIS ENGINEERING, LTD
609 ADEE LANE
GRETNA, LOUISIANA 70056
FIELD STUDY OR LEASE EVALUATION HELP –
CEMENT AND ZONE ISOLATION ANALYSIS
BEFORE LOGGING OR WELL WORKOVER
ILLUSTRATED ON THIS WEBSITE – www.chllogs.com
FIELD STUDY OR LEASE EVALUATION HELP -
LOG KH, FLUID, PRESSURE, AND PRODUCTION ANALYSIS
FOR REVENUE EVALUATION
DONE CONSISTENTLY IN A EXCEL SPREAD SHEETS FORMAT
WORKING IN MY OFFICE - $600.00 PER DAY OR $300.00 PER HALF a DAY
WORKING AT YOUR OFFICE - $900.00 PER DAY OR $600.00 PER HALF a DAY
BILL WHEELIS
PHONE – 1 - 504 – 393 – 0263
E-MAIL – wwheelis@cox.net

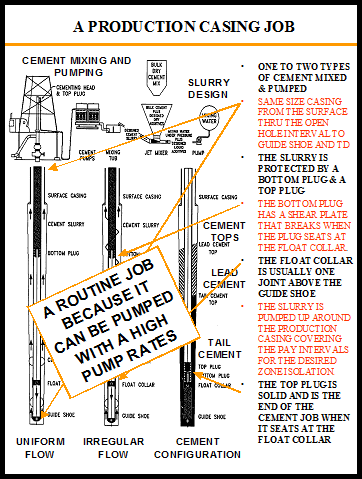

CEMENTING RECIPE EVALUATION -
DID THE PLANNED CEMENT JOB WITH THE SELECTED CEMENTING
RECIPE PERFORM AS DESIGNED AND INTENDED WHEN PUMPED UNDER
THE WELL’S FLOWING HYDRAULICS CONDITIONS FOR CEMENT PLACEMENT,
AND DID THE IN PLACE CEMENT SLURRY CURE AS DESIGNED IN THE
ENVIRONMENT OF THIS WELL AND IN THIS AREA?

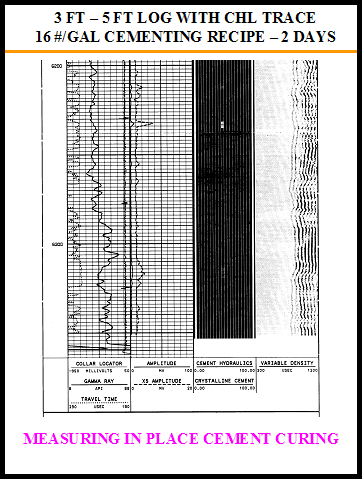

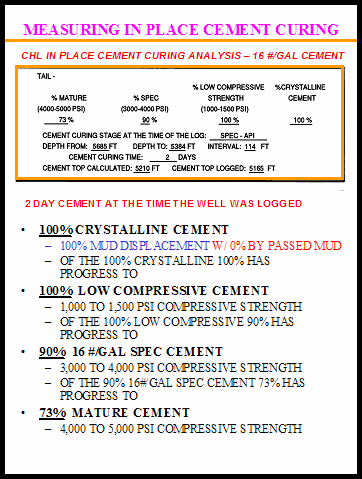

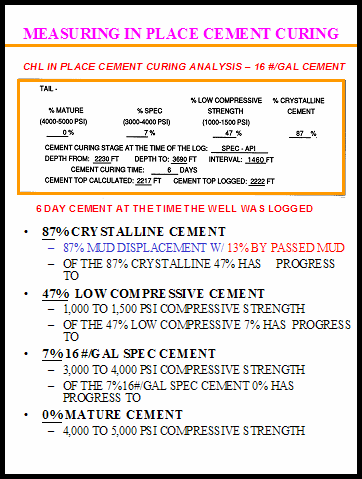

THE CHL INTERPRETATION APPROACH INCLUDES AN IN PLACE CEMENT
CURING COMPRESSIVE STRENGTH ANALYSIS AT THE TIME THE LOG WAS
RUN ACCORDING TO THE WELL’S CASING SIZE, CASING WEIGHT, AND
CEMENT WEIGHT, PLUS THE MEASURE OF DISPLACEMENT EFFICIENCY
TO PROVIDE UNDERSTANDING OF THE HYDRAULICS OF THE CEMENT JOB
AND THE CEMENTING RECIPE’S PERFORMANCE IN THE WELL CONDITIONS
AND ENVIRONMENT OF THIS WELL AND IN THIS AREA

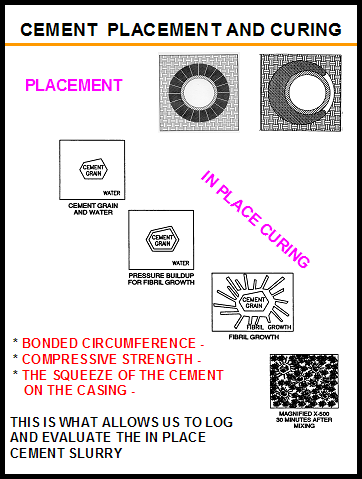

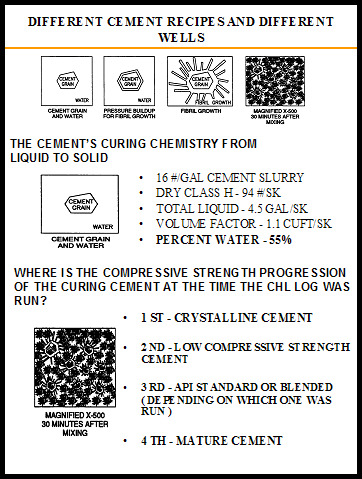

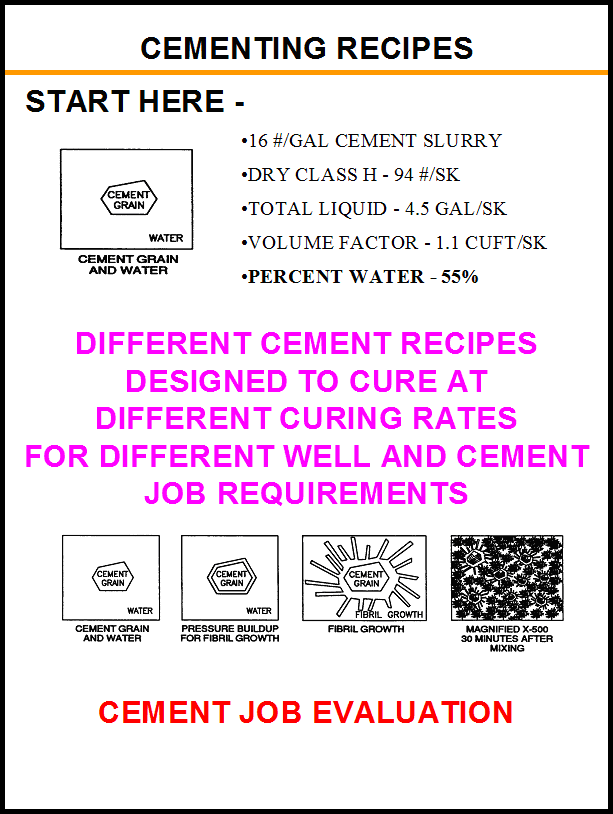

TO REVIEW CEMENT, CEMENT SLURRIES, CEMENT PLACEMENT HYDRAULICS,
AND IN PLACE CEMENT CURING, OPEN THE CEMENT CURING POWER POINT
PRESENTATION –
THE CEMENT CURING POWER POINT PRESENTATION
THE OBLECTIVE OF THE CHL IS TO ASSIST THE CEMENT JOB DESIGNER
EVALUATE THE CEMENT JOB DESIGN ON THE WELL LOGGED LOOKING AT
THE CEMENT JOB DESIGN FOR THE NEXT WELL IN THE AREA.
LOOKING AT WELLS WITH QUESTIONABLE PRODUCTION
---- START YOUR EVALUATION HERE!!!
ON WELLS WITH QUESTIONABLE PRODUCTION, WHAT WOULD BE THE FLUID FLOW MECHANICS
OF A PRODUCING CHANNEL??
1. CHANNEL WIDTH
2. CHANNEL LENGTH AND CONFIGURATION
3. CHANNEL CONTINUITY
4. PRESSURE DIFFERENTIAL AVAILABLE FOR FLOW
5. CHANNEL FLOW RATE
START THE RESEARCH BY REFRESHING THE CEMENT EVALUATION PACKAGE FOR THE WELL USING
THE CHL PROGRAM FOR THE –
1. CHANNEL WIDTH FROM THE CHL
2. CHANNEL LENGTH AND CONFIGURATION FROM THE CHL
3. CHANNEL CONTINUITY FROM THE CHL CEMENT PLACEMENT HYDRAULICS UNDERSTANDING
THEN ADD THE DIFFERENTIAL PRESSURE AND THE FLOW RATE TO ESTABLISH IF THE FLUID
FLOW MECHANICS CONDITIONS ARE SUITABLE FOR CHANNEL FLOW.
E-MAIL THE FOLLOWING TO wwheelis@cox.net
1. THE OPEN HOLE LOG – RESISTIVITY AND POROSITY FOR THE PRODUCTION INTERVAL
2. ZONE’S PRESSURE DATA – INITIAL SHUT IN BOTTOM HOLE PRESSURE,
PRESENT SHUT IN BOTTOM HOLE PRESSURE, PRESENT PRODUCTION
RATE, AND FLOWING BOTTOM HOLE PRESSURE
3. THE MAIN CEMENT EVALUATION LOG FILE IN A PBM OR A PDF FORMAT
4. THE CORRESPONDING LAS DATA FILE FOR THE MAIN CEMENT
EVALUATION LOG WITH THE DEPTH AND THE 3 FT AMPLITUDE VALUES
5. THE WELL SKETCH DATA – CASING SIZE, CASING WEIGHT, AND
CEMENT WEIGHT THRU THE PRODUCTION INTERVAL.

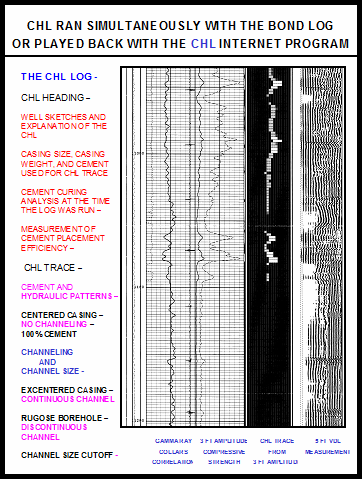

THE CHL TRACE WILL BE INSERTED ON TO THE MAIN CEMENT EVALUATION LOG
FILE WHICH INDICATES CHANNEL SIZE, CHANNEL LENGTH,
CHANNEL CONFIGURATION, AND CHANNEL CONTINUITY. THE RESULTS AND
INTERPRETATION WILL BE PROMPTLY RETURNED FOR YOUR DETERMINATION
IF THE EXISTING FLUID FLOW MECHANICS CONDITIONS MAKE IT POSSIBLE FOR
FLUID FLOW THRU A CHANNEL INTO THE PRODUCTION PERFORATIONS.
ADDING THE CHL TRACE AND THE CHL HEADING FOR THE CHL INTERPRETATION
APPROACH TO YOUR CEMENT EVALUATION PACKAGE CAN BE EASILY DONE.
THE EASY TO RUN, INTERACTIVE CHL TRACE AND CHL HEADING PROGRAM, IS AVAILABLE AT
THE WEBSITE www.addchl.com.
TO REVIEW THE FEATURES OF THE CHL INTERNET PROGRAM AND THE SCREEN SEQUENCE OF THE CHL PROGRAM
DISCUSSED ABOVE, CHECK THE REVIEW CHL PROGRAM BUTTON.
THE OPERATING INSTRUCTIONS ARE AS FOLLOWS:
OPERATING INSTRUCTIONS CAN ALWAYS BE IMPROVED. IF WHEN USING THESE INSTRUCTIONS
SHOULD YOU HAVE ANY SUGGESTED IMPROVEMENTS, PLEASE E-MAIL THE IMPROVEMENTS.
WHEN THEY ARE ADDED TO THE OPERATING INSTRUCTIONS, THEN IN THE FUTURE EVERYONE
CAN TAKE ADVANTAGE OF YOUR SUGGESTED IMPROVEMENTS.

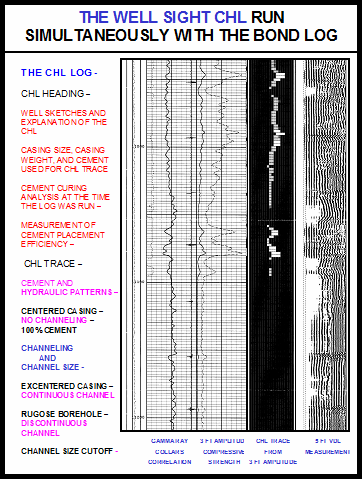

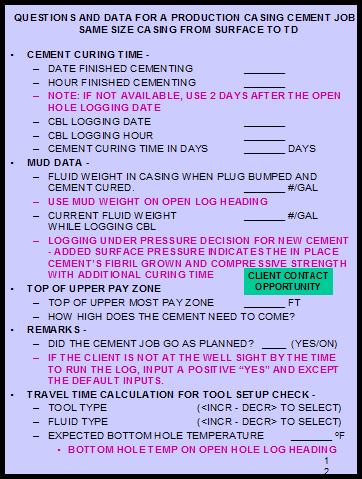

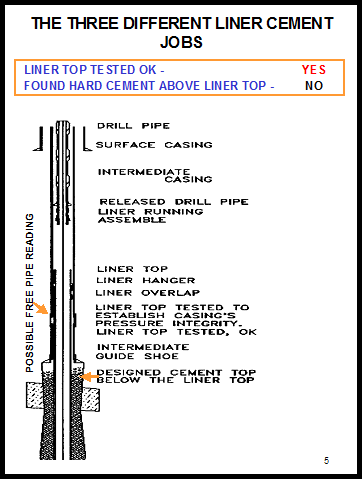

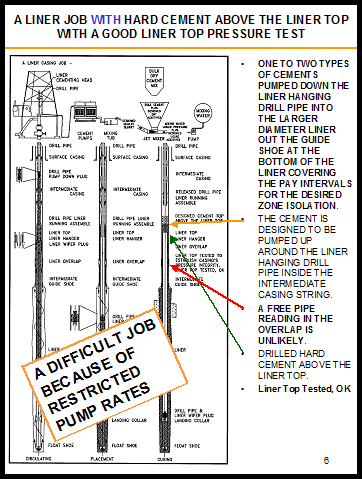

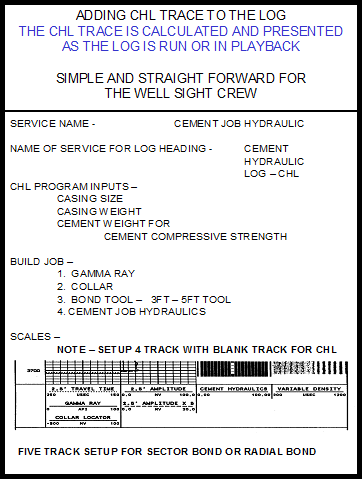

AT THE WELL SIGHT SETUP AND RUN THE CEMENT EVALUATION LOG -

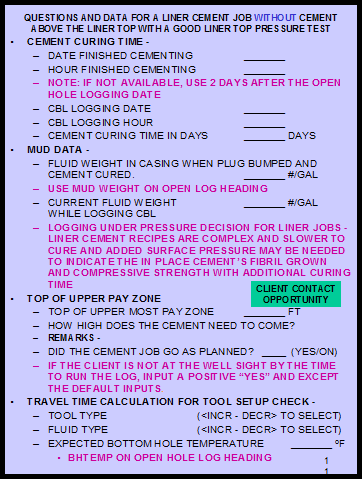

WHEN RUNNING A CEMENT EVALUATION LOG, BE SURE AND ALWAYS LOG THE CEMENT TOPS
SO THE CLIENT CAN ALSO ANALYZE THE CEMENT JOB’S PLACEMENT HYDRAULICS.

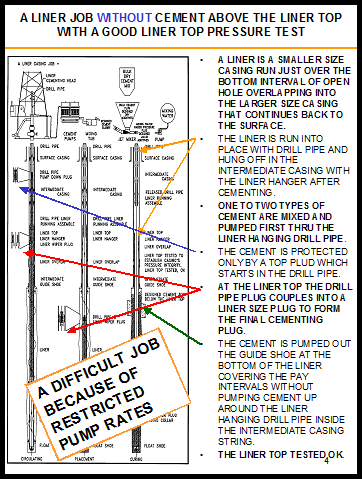

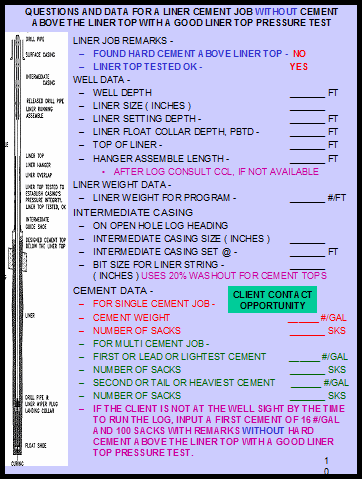

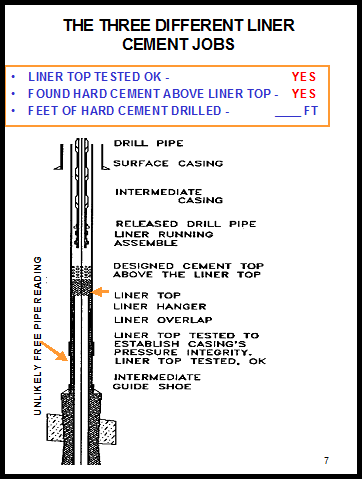

CEMENT TOPS CAN BE IN ONE OF THREE PLACES -
1. IN THE OPEN HOLE INTERVAL
2. IN THE CASING OVERLAP INTERVAL, OR
3. AT THE SURFACE WITH BARRELS OF CEMENT TO SURFACE
IF THE CEMENT DATA IS AVAILABLE AND YOU HAVE TIME AT THE WELL SIGHT, USE THE
FIRST FOUR SCREENS OF ONE OF THE JOB STRUCTURE’S PROGRAM TO CALCULATE THE
CEMENT TOPS TO HELP ORGANIZE THE LOGGING JOB
AT THE WELL SIGHT TO ADD THE CHL TRACE AND THE CHL HEADING -

SET UP A FOLDER ON YOUR COMPUTER FOR THE WELL TO BE ANALYZED. PLACE THE WELL’S
MAIN LOG SECTION PDF FILE OR THE WELL’S MAIN LOG SECTION PBM FILE IN THE FOLDER.
THEN, ADD THE LAS FILE FOR THE MAIN LOG SECTION WITH THE WELL DEPTH AND THE
3 FT AMPLITUDE DATA IN THE WELL’S FOLDER.
LOG ON TO THE INTERNET AND GO TO www.addchl.com. ENTER YOUR USER NAME
AND PASSWORD AND LOG ON TO THE CHL PROGRAM.
PROGRAM NOTE: WHEN LOGGING IN, IF THE PROGRAM DOES NOT MOVE TO THE MAIN CHL PROGRAM
SCREEN, CHECK THE POP-UP BLOCKER. SET THE POP-UP BLOCKER TO OPEN - "SITE POP-UP ALLOWED".
AT THE MAIN CHL PROGRAM SCREEN, SELECT –
NO. 1 JOB STRUCTURE
ON THE FIRST JOB STRUCTURE SCREEN
AT TYPE OF CASING COMPLETION, SELECT ONE OF THE FOLLOWING:
1. FIRST PASS CHL
2. PRODUCTION CASING CEMENTING
3. LINER CEMENTING
4. PRODUCTION CASING WITH STAGE COLLAR CEMENTING
5. PRODUCTION CASING WITH BRADENHEAD CEMENTING
NOTE: THE JOB STRUCTURE CONTAINS THE SEQUENCE OF CHL SCREENS FOR THE WELL AND
CEMENT JOB SELECTED.
FOR JOBS, AT THE WELL SIGHT WITH LIMITED WELL AND CEMENTING DATA AVAILABLE -
AT THE MAIN CHL PROGRAM SCREEN, SELECT –
NO. 1 JOB STRUCTURE
ON THE FIRST JOB STRUCTURE SCREEN
AT TYPE OF CASING COMPLETION, SELECT -
1. FIRST PASS CHL
NOTE: THE JOB STRUCTURE - FIRST PASS CHL -
REQUIRES MINIMUM WELL DATA AND CEMENT DATA INPUTS.
PROGRAM NOTE: NORMALLY, THE LIS NAME FOR THE 3 FT AMPLITUDE FOR MOST LOGGING TOOLS
IS “AM3F” WHICH IS THE DEFAULT FOR THE PROGRAM. IF YOU HAVE ANY PROBLEMS CREATING
THE CHL TRACE IN STEP NO. 3 “PROCESS LOG”, CHECK THE LAS FILE IN NOTEPAD FOR THE
WELL’S 3 FT AMPLITUDE LIS NAME. ON THE FIRST JOB STRUCTURE SCREEN, VERIFY THE
LIS NAME FOR THE 3 FT AMPLITUDE IS INPUT CORRECTLY.
FROM THE JOB TICKET –
PRODUCTION CASING SIZE (INCHES)
WELL DEPTH (FT)
CASING SETTING DEPTH – GUIDE SHOE SET @ (FT)
FLOAT COLLAR – PBTD @ (TD FOR THE LOG) (FT)
(SHOULD BE ONE TO TWO JOINTS ABOVE THE GUIDE SHOE)
SELECTED CASING WEIGHT FOR THE LOG
(SELECT CASING WEIGHT AT WELL’S TD (#/FT)

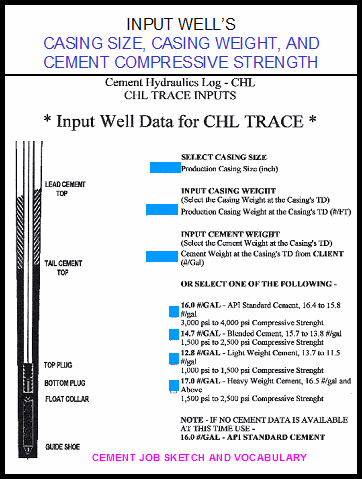

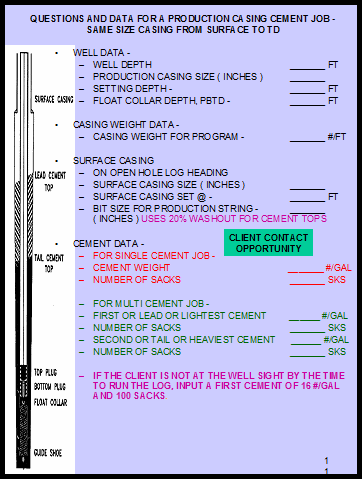

1. SCREEN NO 1 - INPUT WELL DATA –
CASING SIZE
WELL DEPTH
CASING SETTING DEPTH
FLOAT COLLAR – PBTD
LOGGING MUD WEIGHT
CASING WEIGHT - THE WEIGHT AT WELL’S TD
CEMENTING DATA –
NOTE: DETERMINE FROM THE CLIENT, IF THE WELL IS A SINGLE CEMENT JOB, OR
ARE A TWO CEMENT JOB.
CEMENT WEIGHT @ WELL’S TD (#/GAL)
CEMENT SACKS (SKS)
CEMENT VOLUME FACTOR (CUFT/SKS)
NOTE: IF NO CEMENTING DATA IS AVAILABLE AT THIS TIME –
SELECT THE CEMENT WEIGHT – 16.0 #/GAL
CEMENT WEIGHT INPUT –
IF FURNISHED BY THE CLIENT, INPUT THE CEMENT WEIGHT AT THE WELL'S TD OR
SELECT A SUITABLE CEMENT WEIGHT FROM THOSE SUGGESTED ON THE INPUT SCREEN.
2. SCREEN NO. 2 - WELL DATA
CHECK INPUT DATA
3. SCREEN NO. 3 – LOG CHECK AND QUALITY CONTROL VALUES
TOOL DATA
FLUID DATA
FORMATION DATA
CASING DATA
4. SCREEN NO. 4 - LOG CHECK AND QUALITY CONTROL VALUES
CHECK TOOL VALUES
5. SCREEN NO. 5 – CHL LOGGING PARAMETERS
CHECK VALUES
RETURN TO THE MAIN CHL PROGRAM SCREEN
AT THE MAIN CHL PROGRAM SCREEN, SELECT –
NO. 3. PROCESS LOG - TIME REQUIRED 30 TO 90 SECONDS
1. BROWSE TO THE WELL’S FOLDER AND SELECT THE MAIN LOG SECTION LAS FILE.
2. SELECT THE LOGGING COMPANY THAT RAN THE LOG TO SET THE PRE-SET STRETCH
FACTOR AND WIDEN FACTOR.
NOTE: THIS IS TO MATCH THE LOG’S DISPLAY DENSITY TO THE CHL’S DISPLAY DENSITY
OF 200 PIXELS PER INCH
3. SELECT DESIRED TRACK FORMAT – 3 TRACK OR 4 TRACK
4. CREATE CHL TRACK.
NOTE: THIS CREATES THE CHL TRACE IMAGE TO BE PASTED TO THE MAIN LOG SECTION
LATER. THE PROCESS NORMALLY TAKES ABOUT 30 TO 90 SECONDS. THE SCREEN WILL
BE FILLED WITH DEPTH NUMBERS AS THE PROCESS RUNS.
WHEN THE PROCESS IS COMPLETED, THE PROGRAM RETURNS TO THE MAIN CHL SCREEN.
AT THE MAIN CHL PROGRAM SCREEN, SELECT –
NO. 4. INTEGRATION RESULTS
THE INTEGRATION SCREEN SHOULD BE FILLED WITH NUMBERS INDICATING THE LOG SECTION
WAS PROPERLY PROCESSED.
1. RETURN TO THE MAIN CHL PROGRAM SCREEN.
PROGRAM NOTE: IN NO. 3. CREATE THE CHL TRACE, IF THE DEPTH
NUMBER DID NOT APPEAR AND IN NO. 4 INTEGRATIONS RESULTS SCREEN IS NOT
POPULATED, OPEN THE LOG’S LAS FILE IN NOTEPAD AND VERIFY THAT THE LAS NAME FOR
THE 3 FT AMPLITUDE ON THE LOG’S LAS FILE AND LAS PROGRAM INPUT JOB STRUCTURE
SCREEN ARE THE SAME.
AT THE MAIN CHL PROGRAM SCREEN, SELECT –
NO. 5. PLOT HEADER INSERTS - TIME REQUIRED 30 TO 90 SECONDS
1. BROWSE TO THE WELL’S FOLDER AND SELECT THE MAIN LOG SECTION PDF OR PBM FILE
2. CREATE HEADERS. CHECK THE CHL HEADING DATA INPUTS
3. SUBMIT HEADERS.
NOTE: THIS PROCESS ADDS THE CHL HEADING IMAGES TO THE MAIN LOG SECTION. THE PROCESS
NORMALLY TAKES ABOUT 30 TO 90 SECONDS. ON THE LEFT OF THE SCREEN THE HEADING
INSERTS WILL APPEAR AS THEY ARE SUBMITTED. WHEN THE PROCESS IS COMPLETED,
THE PROGRAM RETURNS TO THE MAIN CHL SCREEN
AT THE MAIN CHL PROGRAM SCREEN, SELECT –
NO. 6. MERGE LOG RESULTS - TIME REQUIRED 30 TO 90 SECONDS TO LOAD SCREEN
NOTE: FOR THE LOG WITH THE CHL HEADING IMAGES AND THE MAIN LOG SECTION TO BE
TRANSFERRED TO YOUR COMPUTER, IT WILL TAKE ONE TO TWO MINUTES.
1. FOLLOW THE INSTRUCTIONS ON THE SCREEN AND OVERLAY THE CHL TRACE IMAGE AT
THE CORRECT DEPTH, PLUS ADD THE CHL SCALES AT THE TOP AND BOTTOM OF THE
CHL TRACE IMAGE TO COMPLETE THE LOG.
NOTE: THE CHL TRACE IS A LARGE FILE AND WILL TAKE A 30 TO 90 SECONDS TO APPEAR.
2. RETURN TO THE TOP OF THE CHL SCREEN AND SAVE CHANGES TO FILE.
THE PROGRAM RETURNS TO THE MAIN CHL SCREEN
AT THE MAIN CHL PROGRAM SCREEN, SELECT –
NO. 7. VIEW FINAL RESULTS - TIME REQUIRED 30 TO 90 SECONDS TO LOAD SCREEN
1. REVIEW THE LOG RESULT.
NOTE: FOR THE FINAL LOG WITH THE CHL HEADING IMAGES AND CHL TRACE IMAGE ADDED
TO THE MAIN LOG SECTION TO COME UP, IT WILL TAKE ONE TO TWO MINUTES.
2. IF THE LOG IS SATISFACTORY, DOWNLOAD THE FINAL LOG AS A PDF OR A PBM FILE
INTO THE WELL’S FOLDER.
3. RETURN TO THE MAIN CHL PROGRAM SCREEN.
AT THE MAIN CHL PROGRAM SCREEN, SELECT –
NO. 8 SAVE DATA INPUTS
1. PASTE THE DATA INPUT DATA TO A NOTEPAD TEXT FILE AND SAVE IT IN THE
WELL’S FOLDER.
NOTE: ON CHL LOG UPDATES FOR THIS WELL, THE DATA CAN BE RESTORED TO THE PROGRAM FOR
EDITING AND ADDITIONS WITHOUT HAVING TO RE-TYPE EACH SCREEN’S DATA INPUT.
2.RETURN TO THE MAIN CHL SCREEN.
AT THE MAIN CHL PROGRAM SCREEN, SELECT –
LOG OFF
TO END CHL LOGGING SESSION
THE WELL’S FOLDER SHOULD BE COMPLETE WITH THE FOLLOWING FILES –
1. LAS FILE OF THE MAIN LOG SECTION WITH DEPTH AND THE 3 FT AMPLITUDE
2. PDF FILE OF THE MAIN LOG SECTION
3. TEXT FILE OF THE DATA INPUTS USED
4. PDF FILE OF THE FINAL LOG WITH THE CHL TRACE AND HEADING
E-MAIL THE FOLDER TO SALES AND THE CLIENT FOR THE UP OR DOWN CEMENT EVALUATION
MEETING. THE CHL JOB IS FINISHED AT THE WELL SIGHT.
CHL CEMENT TOP CALCULATIONS –
CEMENT TOPS CAN BE IN THREE PLACES -
1. IN THE OPEN HOLE INTERVAL
2. IN THE CASING OVERLAP INTERVAL, OR
3. AT THE SURFACE WITH BARRELS OF CEMENT TO SURFACE
CEMENT – COLOR CODED CORAL AND LIGHT GREEN
THE VOLUME OF CEMENT = NUMBER OF SACKS X THE CEMENT VOLUME FACTOR (CUFT/SACK)
1. A SINGLE CEMENT SYSTEM – FIRST CEMENT COLOR CODED “CORAL”
2. A TWO CEMENT SYSTEM WITH A LEAD CEMENT AND A TAIL CEMENT - SECOND CEMENT COLOR
CODED “LIGHT GREEN”
HOLE DIAMETERS – COLOR CODED YELLOW
1. DIAMETER WITH 20% WASHOUT
2. DIAMETERS CALCULATED FROM CEMENT TOPS – THE HYDRAULIC WELL DIAMETERS
3. DIAMETERS MEASURED FROM THE OPEN HOLE LOG CALIPER
THE CHL PROGRAM SCREENS ARE SETUP TO HELP CALCULATE THE CEMENT TOPS AND HOLE DIAMETERS
FOR THE CHL HEADING.

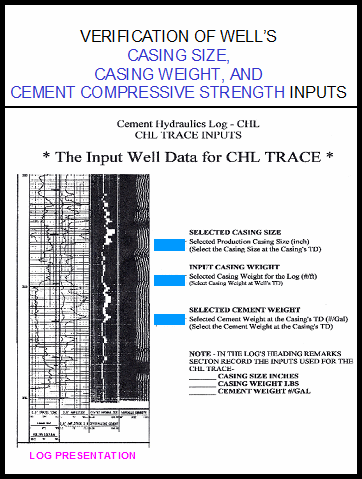

ON THE “INPUT WELL DATA” SCREEN
1. THE WELL DATA AND CEMENT DATA ARE INPUT.
ON THE “LOGGED CEMENT TOP – HYDRAULIC DIAMETER” SCREEN –
1. THE CEMENT TOPS OF THIS SCREEN ARE BASED ON AN ESTIMATED HOLE SIZE WITH
20% WASHOUT – DIAMETER NO. 1.
2. ON THIS SCREEN, INPUT THE LOGGED CEMENT TOPS TO DETERMINE THE HYDRAULIC HOLE
SIZES – DIAMETERS NO. 2.
ON THE “UPPER MOST PAY & HOLE VOLUME DATA” SCREEN IF THE HOLE VOLUME IS AVAILABLE
1. INPUT AN INTERVAL
2. INPUT THE MEASURED HOLE VOLUME FOR THAT INTERVAL
3. THE MEASURED HOLE DIAMETER FOR THAT INTERVAL WILL BE CALCULATED – DIAMETER NO. 3
ON THE “FROM THE HYDRAULIC DIAMETER & THE HOLE VOLUME DIAMETER & THE 20% WASHOUT DIAMETER,
INPUT THE MOST CORRECT HOLE DIAMETER” SCREEN SELECT AND INPUT THE HOLE DIAMETER FOR THE
MOST CORRECT CEMENT TOPS FOR THESE WELL CONDITIONS FROM ONE OF THE FOLLOWING -
1. INPUT DIAMETER NO. 1 – 20% WASHOUT DIAMETER
2. INPUT DIAMETER NO. 2 – HYDRAULIC DIAMETERS FROM LOGGED CEMENT TOPS
3. INPUT DIAMETER NO. 3 – HOLE VOLUME DIAMETERS FORM CALIPER DATA
ON JOBS, WITH CLIENT EXCHANGE AND INPUT BEFORE AN INITIAL CHL OR
THE FOLLOWUP SALES CALL WITH THE CLIENT THAT DESIGNED THE CEMENT JOB -
AT THE MAIN CHL PROGRAM SCREEN, SELECT –
NO. 1 JOB STRUCTURE
ON THE FIRST JOB STRUCTURE SCREEN
AT TYPE OF CASING COMPLETION, SELECT ONE OF THE FOLLOWING:
2. PRODUCTION CASING CEMENTING
3. LINER CEMENTING
4. PRODUCTION CASING WITH STAGE COLLAR CEMENTING
5. PRODUCTION CASING WITH BRADENHEAD CEMENTING
PROGRAM NOTE: NORMALLY, THE LIS NAME FOR THE 3 FT AMPLITUDE FOR MOST LOGGING TOOLS
IS “AM3F” WHICH IS THE DEFAULT FOR THE PROGRAM. IF YOU HAVE ANY PROBLEMS CREATING
THE CHL TRACE IN STEP NO. 3 “PROCESS LOG”, CHECK THE LAS FILE IN NOTEPAD FOR THE
WELL’S 3 FT AMPLITUDE LIS NAME. ON THE FIRST JOB STRUCTURE SCREEN, VERIFY THE
LIS NAME FOR THE 3 FT AMPLITUDE IS INPUT CORRECTLY.
AT THE JOB STRUCTURE SCREEN - "INPUT WELL DATA"-
INPUT THE FOLLOWING:
1. FROM THE JOB TICKET –
PRODUCTION CASING SIZE (INCHES)
WELL DEPTH (FT)
CASING SETTING DEPTH – GUIDE SHOE SET @ (FT)
FLOAT COLLAR – PBTD @ (TD FOR THE LOG) (FT)
(SHOULD BE ONE TO TWO JOINTS ABOVE THE GUIDE SHOE)
2. SELECTED CASING WEIGHT FOR THE LOG
(SELECT CASING WEIGHT AT WELL’S TD (#/FT)
3. FROM THE TIE-IN OPEN HOLE LOG HEADING
SURFACE OR INTERMEDIATE CASING SIZE (INCHES)
SETTING DEPTH - SURFACE OR INTERMEDIATE CASING GUIDE SHOE DEPTH (FT)
BIT SIZE (INCHES)
NOTE: THE PROGRAM NEEDS THE BIT SIZE DATA TO BE ABLE TO CALCULATE THE
INITIAL CEMENT TOPS.
4. CEMENTING DATA –
NOTE: DETERMINE WITH THE CLIENT, IF THE WELL HAS A SINGLE CEMENT JOB OR A TWO CEMENT JOB.
CEMENT WEIGHT @ WELL’S TD (#/GAL)
CEMENT SACKS (SKS)
CEMENT VOLUME FACTOR (CUFT/SKS)
NOTE: IF NO CEMENTING DATA IS AVAILABLE AT THIS TIME USE –
CEMENT WEIGHT – 16.0 #/GAL
CEMENT SACKS – 100 SKS
5. PROCEED THRU THE REST OF THE JOB STRUCTURE SCREENS AND INPUT REQUESTED DATA
AS AVAILABLE UNTIL YOU ARE BACK AT THE MAIN CHL PROGRAM SCREEN.
NOTE: IF THE REQUESTED DATA IS NOT AVAILABLE AT THIS TIME, SKIP THE SCREEN AND PROCEED
TO THE NEXT SCREEN. LATER, WITH CLIENT INPUT MORE DATA CAN BE INCLUDED.
AT THE MAIN CHL PROGRAM SCREEN, SELECT –
NO. 3. PROCESS LOG
1. BROWSE TO THE WELL’S FOLDER AND SELECT THE MAIN LOG SECTION LAS FILE.
2. SELECT THE LOGGING COMPANY THAT RAN THE LOG TO SET THE PRE-SET STRETCH FACTOR AND
WIDEN FACTOR.
NOTE: THIS IS TO MATCH THE LOG’S DISPLAY DENSITY TO THE CHL’S
DISPLAY DENSITY OF 200 PIXELS PER INCH.
3. SELECT DESIRED TRACK FORMAT – 3 TRACK OR 4 TRACK
4. CREATE CHL TRACK.
NOTE: THIS CREATES THE CHL TRACE IMAGE TO BE PASTED TO THE MAIN LOG SECTION LATER.
THE PROCESS NORMALLY TAKES ABOUT A MINUTE. THE SCREEN WILL BE FILLED WITH DEPTH NUMBERS
AS THE PROCESS RUNS.
WHEN THE PROCESS IS COMPLETED, THE PROGRAM RETURNS TO THE MAIN CHL SCREEN.
AT THE MAIN CHL PROGRAM SCREEN, SELECT –
NO. 4. INTEGRATION RESULTS
THE INTEGRATION SCREEN SHOULD BE FILLED WITH NUMBERS INDICATING THE LOG SECTION WAS
PROPERLY PROCESSED.
1. RETURN TO THE MAIN CHL PROGRAM SCREEN.
PROGRAM NOTE: IN "NO. 3. CREATE THE CHL TRACE", IF THE DEPTH NUMBER DID NOT APPEAR
AND IN "NO. 4 INTEGRATIONS RESULTS", IF THE SCREEN IS NOT POPULATED, OPEN THE
LOG’S LAS FILE IN NOTEPAD AND VERIFY THAT THE LAS NAME FOR THE 3 FT AMPLITUDE
ON THE LOG’S LAS FILE AND LAS PROGRAM INPUT ARE THE SAME.
AT THE MAIN CHL PROGRAM SCREEN, SELECT –
NO. 5. PLOT HEADER INSERTS
1. BROWSE TO THE WELL’S FOLDER AND SELECT THE MAIN LOG SECTION PDF OR PBM FILE
2. CREATE HEADERS. CHECK THE CHL HEADING DATA INPUTS
3. SUBMIT HEADERS.
NOTE: THIS PROCESS ADDS THE CHL HEADING IMAGES TO THE MAIN LOG SECTION.
THE PROCESS NORMALLY TAKES ABOUT A MINUTE. ON THE LEFT OF THE SCREEN THE HEADING INSERTS
WILL APPEAR AS THEY ARE SUBMITTED.
WHEN THE PROCESS IS COMPLETED, THE PROGRAM RETURNS TO THE MAIN CHL SCREEN
AT THE MAIN CHL PROGRAM SCREEN, SELECT –
NO. 6. MERGE LOG RESULTS
NOTE: FOR THE LOG WITH THE CHL HEADING IMAGES AND THE MAIN LOG SECTION TO BE TRANSFERRED

TO YOUR COMPUTER, IT WILL TAKE ONE TO TWO MINUTES.
1. FOLLOW THE INSTRUCTIONS ON THE SCREEN AND OVERLAY THE CHL TRACE IMAGE AT THE CORRECT
DEPTH, PLUS ADD THE CHL SCALES AT THE TOP AND BOTTOM OF THE CHL TRACE IMAGE TO COMPLETE
THE LOG.
NOTE: THE CHL TRACE IS A LARGE FILE AND WILL TAKE A FEW SECONDS TO APPEAR.
2. RETURN TO THE TOP OF THE CHL SCREEN AND SAVE CHANGES TO FILE.
THE PROGRAM RETURNS TO THE MAIN CHL SCREEN
AT THE MAIN CHL PROGRAM SCREEN, SELECT –
NO. 7. VIEW FINAL RESULTS
1. REVIEW THE LOG RESULT.
NOTE: FOR THE FINAL LOG WITH THE CHL HEADING IMAGES AND CHL TRACE IMAGE ADDED TO
THE MAIN LOG SECTION TO COME UP, IT WILL TAKE ONE TO TWO MINUTES.
2. IF THE LOG IS SATISFACTORY, DOWNLOAD THE FINAL LOG AS A PDF OR A PBM FILE INTO
THE WELL’S FOLDER.
3. RETURN TO THE MAIN CHL PROGRAM SCREEN.
AT THE MAIN CHL PROGRAM SCREEN, SELECT –
NO. 8 SAVE DATA INPUTS
1. PASTE THE DATA INPUT DATA TO A NOTEBOOK TEXT FILE AND SAVE IT IN THE WELL’S FOLDER.
NOTE: ON THE NEXT CHL LOG UPDATE FOR THIS WELL, THE DATA CAN BE RESTORED TO THE
PROGRAM FOR EDITING AND ADDITIONS WITHOUT HAVING TO RE-TYPE EACH SCREEN’S DATA INPUT.
2.RETURN TO THE MAIN CHL SCREEN.
AT THE MAIN CHL PROGRAM SCREEN, SELECT –
LOG OFF
TO END CHL LOGGING SESSION
RESTORING THE DATA INPUT VALUES FOR A LATER CHL UPDATE –
1. OPEN AND LOG ON TO THE CHL PROGRAM
2. IN THE LOG’S FOLDER OPEN THE TEXT FILE IN NOTEPAD.
3. HIGH LIGHT AND COPY ALL THE DATA IN THE FILE FROM THE TOP DASHED LINE TO THE BOTTOM DASHED LINE
4. CLOSE THE NOTEPAD AND RETURN TO THE MAIN CHL PROGRAM SCREEN
AT THE MAIN CHL PROGRAM SCREEN, SELECT –
NO. 9 RESTORE DATA INPUTS
1. RIGHT CLICK AND PASTE THE WELL’S DATA INPUTS
2. IMPORT DATA AND CLICK OK
3. RETURN TO THE MAIN CHL PROGRAM SCREEN
NOTE: ALL THE WELL’S DATA FROM THE PREVIOUS CHL PROGRAM SESSION ON EACH CHL
PROGRAM SCREEN HAVE BEEN RESTORED.
TO REVIEW THE FEATURES OF THE CHL PROGRAM AND THE SCREEN SEQUENCE OF THE CHL PROGRAM
DISCUSSED ABOVE, CHECK THE REVIEW CHL PROGRAM BUTTON.
FOR A SINGLE WELL CHL TRACE AND CHL HEADING USAGE AGREEMENT, MAKE A PAYMENT OF $350.00
THRU PAYPAL AND CONTACT BILL WHEELIS TO HAVE A USER NAME AND PASSWORD SET UP FOR THE
WELL. CONTACT BY PHONE 1 - 504 - 393 - 0299 OR E-MAIL AT wwheelis@cox.net
FOR THE CONVENIENCE OF A LONG TERM MONTHLY CHL TRACE AND CHL HEADING USAGE AGREEMENT
BASED ON EXPECTED LONG TERM PROGRAM USAGE, CONTACT BILL WHEELIS BY PHONE
PHONE 1 - 504 - 393 - 0299 OR E-MAIL AT wwheelis@cox.net TO SET UP A MEETING.
